erpkaizen

Measuring the value

The ROI of replacing a dispatch spreadsheet with a grid inside the ERP

Has a measurement 23/09/2026 About 8 min
A shared Google Sheet!one slip per order, totalled by hand The same grid, inside the ERPERPPick listDelivery manifest
Left: one shared file, four teams editing it, a broken formula, and an output of loose slips totalled by hand. Right: the same grid inside the ERP, producing two consolidated documents.

The outbound plan almost always starts as a shared sheet, and it genuinely works until a few hundred orders a day. The cure is not forcing people back into ERP forms — it is putting the spreadsheet inside the system.

What are two hours of dispatch worth?

All it needs is daily volume and the dispatch time left after the change. Labour, hired-in vehicles and reconciliation follow from those — every one of them editable.

Total orders leaving the warehouse, across all shifts
What is left once the system batches and routes on its own
Preparation time per shift

This is administrative labour, not how much earlier the truck rolls. The part actually on the vehicle's critical path is far smaller — the source estimates about 45 minutes a shift.

Assumptions — click to see and change every number

People and labour

Fleet

Errors and reconciliation

Implementation

Where the benefit comes from Hover a bar to see how it is built
Dispatch and warehouse hours
Less hired-in transport
Fewer wrong deliveries
Less COD reconciliation
Total benefit / month
Total benefit / year
Implementation cost
Pays back in

This is an estimate, not a promise. 'Less hired-in transport' is the softest line and only holds if you are actually paying for hired-in vehicles — if not, set it to zero and read the total again.

In a distribution business, the outbound plan almost always starts life as a shared Google Sheet. And it works — visual, flexible, instant. That is why it survives so long, not because anyone is avoiding the ERP.

The trouble only shows past a few hundred orders a day. And the usual cure is the wrong one: push the dispatchers back into the ERP's data-entry forms. This piece quantifies the other cure — keep the spreadsheet experience and put it inside the ERP.

1. Where the shared file breaks

Not because spreadsheets are bad. Because of three things a spreadsheet cannot have.

  1. Nobody owns a row. Several teams have it open, a VLOOKUP hangs, and one dragged row or deleted cell stalls the whole day's dispatching. Nothing errors.
  2. Copy-paste eats the first two to three hours of the shift. Filter by route, copy into each driver's tab, print orders one by one, then add them up by hand to produce the picker's list and the driver's manifest.
  3. The dispatch numbers and the stock numbers are two different truths. Goods assigned to a driver that the ERP has not deducted; or stock that ran out while the sheet keeps allocating it. The result is failed deliveries, and then the cost of delivering again.

The third is a copy of what the first piece called fragmented data. Here it does not sit between departments — it sits between a file and the system.

2. What the improvement actually is

Not abandoning the spreadsheet. Moving it inside the system.

  1. Keep the grid. Keyboard shortcuts, column filters, drag-fill, multi-row paste. No retraining, and more importantly no reason to drift back to the old file.
  2. Batch and route automatically. By area, by route, by vehicle capacity — the part people do slowly and inconsistently, and a machine does quickly and the same way every time.
  3. Print once per trip. One consolidated pick list so the warehouse walks the floor once, and one manifest carrying barcodes, the stop list, the COD to collect and a signature line.
  4. Approving a trip is a posting, not an announcement. Press approve and stock is reserved, the issue is created, and the COD lands on the right person's account. That is the real difference from a spreadsheet.

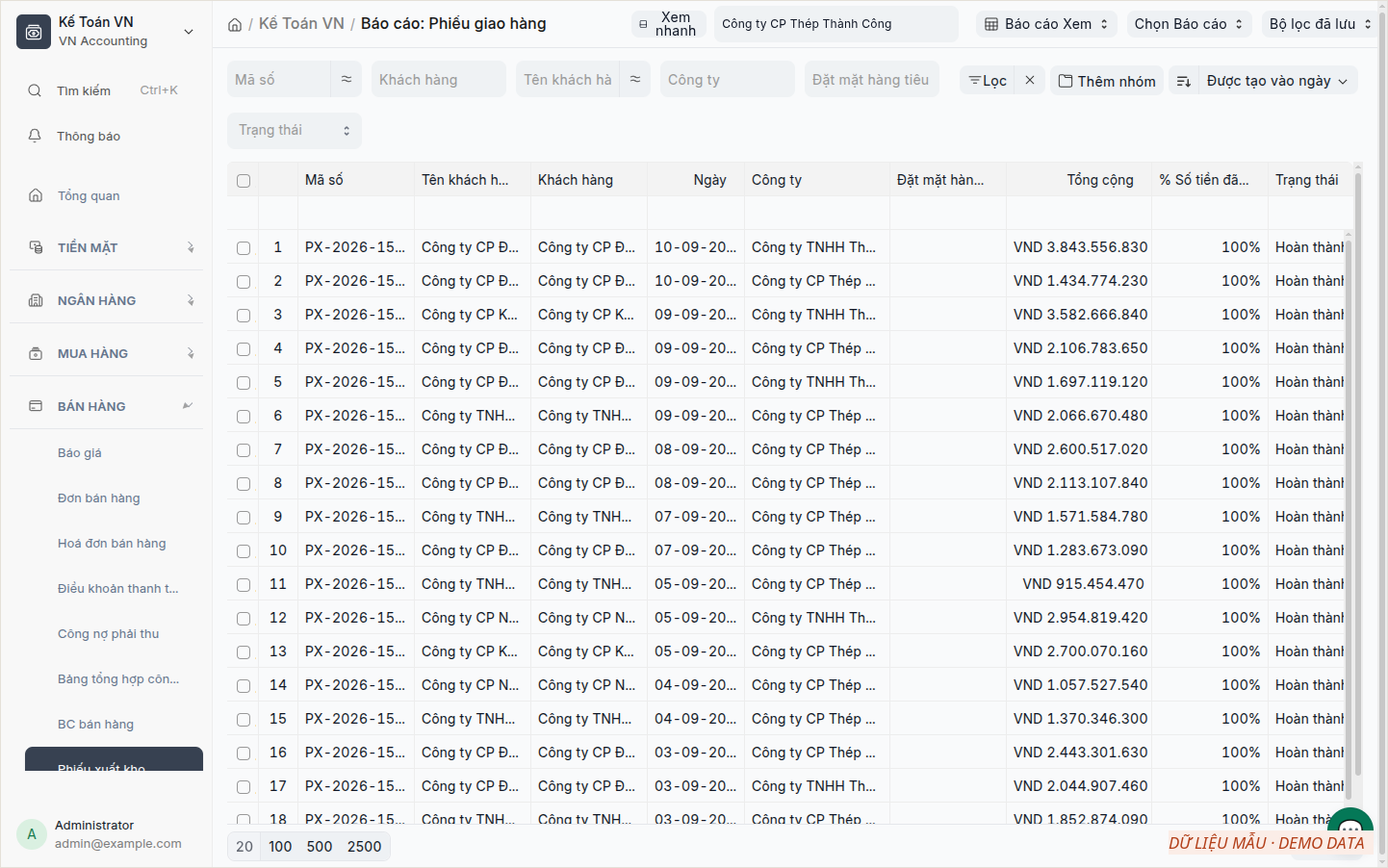

Delivery notes in a grid view, filtered and sorted by column inside the ERP
This is what the piece is about: a spreadsheet-like grid that lives inside the ERP. Filter by column, select rows, change the page size — the familiar handling survives, while the numbers are the system's own rather than a copy. The 306 notes shown are machine-generated demo data.

3. Four numbers, and which one to trust

A. Dispatch and warehouse hours

Saving per month = (dispatch hours saved × dispatch hourly cost + warehouse hours saved × warehouse hourly cost) × working days

The firmest, because it rests only on time you can put a stopwatch on. Measure one shift and you have your baseline.

Example 2 dispatchers × 2.5 hours × 2 shifts = 10 hours a day, down to 1 after the change → 9 hours saved. The warehouse spends 1.5 hours × 2 shifts totalling pick lists by hand = 3 hours. (9 × 80,000 + 3 × 60,000) × 26 = 23,400,000 đ a month → 280,800,000 đ a year.

B. Less hired-in transport, by leaving the yard earlier

Leaving earlier dodges the peak and fits in more stops. But this is the softest line, and it only holds if you are genuinely paying for hired-in vehicles. If you are not, set it to zero and read the total again — what remains is still large.

One confusion worth naming: freeing 12 hours of administrative labour a day does not mean the truck rolls 12 hours earlier. Most of that work sits off the vehicle's critical path. The part that actually moves departure is much smaller — the source estimates about 45 minutes a shift.

C. Fewer wrong deliveries

Saving = orders per month × share that go wrong × cost of carrying back, repacking and redelivering

Most of these errors are not carelessness. They start as one dragged row in a file four people have open at once.

D. Less COD reconciliation

The manifest locks in what each driver owes, so the end-of-day addition disappears. The smallest of the four, and the easiest to verify inside a week.

4. A mid-sized example

15 trucks and 20 motorbikes, 600 orders a day, two dispatch shifts.

LinePer monthPer year
Dispatch and warehouse hours23.4m280.8m
Less hired-in transport15.0m180.0m
Fewer wrong deliveries3.0m36.0m
Less COD reconciliation1.8m21.8m
Total, against 80m of implementation43.2mpays back in ~1.85 months

The estimator above reproduces this table: three of the four lines match exactly, the total is within 0.3%, and payback lands on 1.85 months.

5. What to take away

People cling to the Google Sheet because it is convenient, not because they are resisting the ERP. This is where a great many projects misread the motive and pick the wrong cure. If the new system is slower to type into than the old tool, people go back to the old tool, whatever the policy says. The only way to beat a spreadsheet is to put the spreadsheet experience inside the system — and then add the things a spreadsheet cannot do.

And as with the piece on templates, what makes this worth doing early is not that it is the biggest, but that the people using it feel the benefit in the first shift.

A process only survives if it is faster than the shortcut around it. Taking away a convenient tool without handing back a more convenient one is not an implementation. It is a bet on discipline.

The figures illustrate a mid-sized distributor and are not taken from any client's system. Replace them with your own in the estimator above.
