Measuring the value

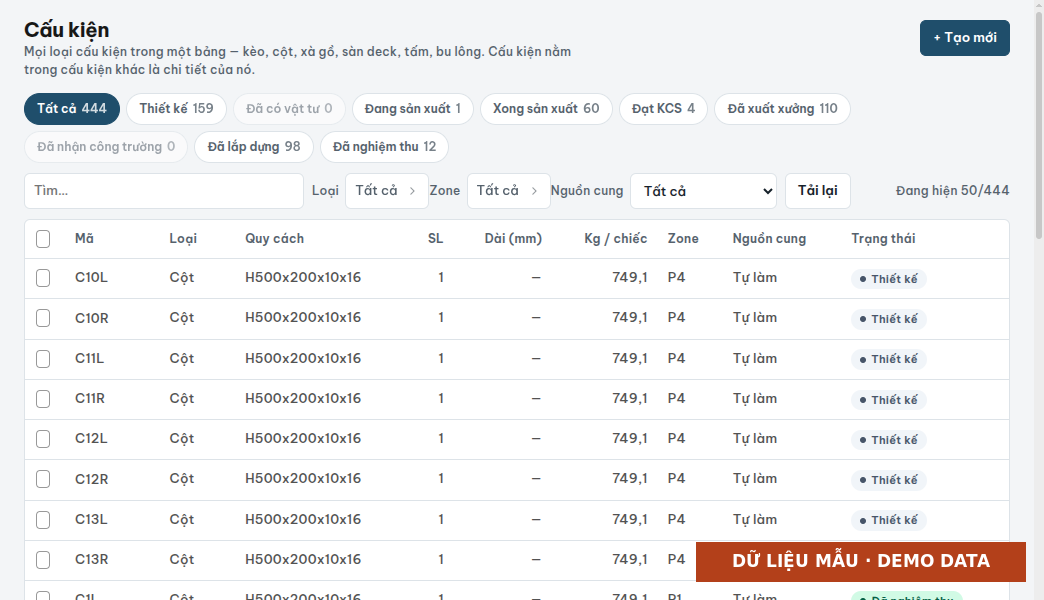

Read the IFC model into a component catalogue in the ERP, so estimating, purchasing, the shop and the site stop queuing behind the design software: the money comes from four sources, each can be measured in your own company, and the ROI still holds when you drop the source you are least sure of.
All it needs is tonnes per year, the share of that tonnage with a usable IFC model, and the paid software seats held outside detailing. Every revenue-scale figure follows from those — and every one is editable.
Derived from the three numbers above
Licences
Labour
Steel scrap
Rework from wrong marks
Time and cost
This is an estimate, not a promise. Line D is the softest — set it to zero and read the total again. Set the model share, the bid share and the seats to zero: every benefit goes to zero with them, and only the cost is left.
At a structural steel EPC contractor, the Tekla model is the most complete record of the building there is: every assembly, every part, every bolt, with its profile, length, weight and paint area. The trouble is that only the detailing team can open it comfortably. Estimating, purchasing, the shop, the site and accounts all need those numbers — and each of them gets hold of them in its own expensive way.
This piece works out the ROI of taking the model out of the design software: export it to IFC, read it into a component catalogue in the ERP, and let every department work from that catalogue instead of from the model. The money comes from four sources — software licences, labour, steel scrap, and rework caused by wrong piece marks. For each one, the piece shows how to calculate it, how to measure it in your own company, and how far to trust it.
In most companies, the data in the model reaches the other departments by one of three routes:
All three cost money in four places: licence fees; hours spent counting, re-keying and reporting; steel bought by rule of thumb instead of by the parts that actually have to be cut; and the times a piece reaches site with the wrong mark, missing fittings, or out of erection order. None of them shows up as a line in a management report.
The detailers keep Tekla. Everybody else uses the catalogue.

Tekla does not go away. The model simply stops being the place the whole company has to queue up to read.
How to measure it. This is the only source whose number is already printed on an invoice. Pull the licence server log for the last 90 days: who opened the software, in which department, how often. Any seat used only to look at the model and look up numbers is a seat the catalogue can replace.
How far to trust it: the most — with a condition. If those departments already view the model in a free viewer, this line is zero, however good the arithmetic looks. And it only becomes money at renewal, when the licence contract is actually cut.
The share of work that has a model is the factor most easily forgotten. At tender stage, most projects do not have a detailed model yet — it is usually built only after the contract is signed. Bids that arrive with nothing but 2D drawings take a different route, as the piece on reading drawings into a quotation worked out. The 50% in the example is a placeholder: count how many of your last 20 bids came with a usable IFC model. In the shop it is different — a signed project always has a model, because the company builds it.
How to measure it. Time three takeoffs before and after. In the shop, log for two weeks the time foremen spend on paperwork and end-of-day reports, before and after scanning.
When hours become money. As the piece on keyboard shortcuts put it, freed hours only become money when they go into work that has a price: less overtime, no new hire when volume grows, or moving people onto harder work. Submitting a bid faster — in days rather than weeks — is real, but it is the same hours used differently; the calculator does not count it a second time.
The easiest mistake to make here is to value the steel saved at its purchase price. Offcuts are not a total loss — they become scrap, and scrap sells. Valued at the purchase price, the same 90 tonnes come to 1.5 billion, nearly twice the real figure.
How to measure it. For every finished project, compare the total steel bought with the total steel shipped as pieces; the monthly scrap sales invoices are the cross-check. Six to twelve months of data is enough to know your company's current scrap rate.
How far to trust it: medium, even though this is the largest source. Nesting software is a tool of its own; the catalogue only gives it correct data, earlier. If the shop already nests on its CNC machines, the reduction will be much smaller — which is why the scrap baseline has to be taken before you start, not after.
How to measure it. If the company keeps a non-conformance log, each entry already records its cause and the cost of putting it right; filter the ones that trace back to a piece mark, a quantity or a sequence. If there is no such log, the first job is to start one — and to keep it for three months before trusting any number in this line.
How far to trust it: the least. 0.1% is an assumption, not a measurement. Set it to zero and read the total again.
With the default assumptions in the calculator above, once the system is running in full:
| Source | Per month | Per year |
|---|---|---|
| Software licences | 47.3 M | 568.0 M |
| Estimating and shop labour | 34.8 M | 417.6 M |
| Less steel scrap | 65.3 M | 783.0 M |
| Less rework from wrong marks | 31.5 M | 378.0 M |
| Total at full run | 178.9 M | 2,146.6 M |
But no system runs in full from its first month. The shop needs time to get used to scanning, purchasing needs a few lots before it trusts the nesting lists, and licences can only be cut at renewal. The calculator ramps the benefit up over the first 6 months. With an investment of 500 million in the first year and 120 million a year after that for the server, support and updates:
The chart in the calculator stacks the sources by how certain they are: licences at the bottom, rework at the top. The top of each column is the softest part of the number.
Two assumptions decide the most, and they are of different kinds:
Lower each of them to see whether the calculation still stands:
The last scenario still pays back within the first year. That is the number to take into the investment meeting, not 710%. And if you set the share of output with a model, the number of seats and the share of bids with a model all to zero, every benefit goes to zero with them and only the cost is left — exactly as an honest model should.
The first step has to happen before the change goes live — without a baseline there is no ROI.
Licences and labour will be clear within a few months. Steel scrap and rework need a year of data to show — so do not make them a condition of approving the investment; track them as the upside.
The model is where the data is created; the catalogue is where it is used. When the two are the same thing, every department queues behind one expensive piece of software and one person who knows how to use it. Separating them does not make the model any worse — it lets every number in it reach the person who needs it, under the same mark, from the drawing to the site.
Don't ask how much this software saves. Ask: if you drop the source of money you are least sure of, does it still pay back in the first year?
The figures in this piece are illustrative, for a structural steel contractor producing about 1,000 tonnes a month; they are not taken from any client's system. Licence fees, steel prices and scrap prices change over time — replace them with the numbers on your own invoices in the calculator above.
